Discovery Museum: Energy
For this project, we were tasked with designing and building a series of exhibits based on provided visual representations and functional descriptions. My primary focus was on overall project management and electronics integration.
- Client
- Discovery Museum
- Role
- Project management, electronics integration
- Schedule
- Ten exhibits over 31 weeks
- On site
- Delivery, installation, testing, emergency repairs

I collaborated with team members to create a project schedule, which was then translated into this Gantt chart.

From there, I ensured that everyone was informed about their tasks and timelines. I also contributed to the build process, with the Energy Portfolio being one of my favorite exhibits. My role primarily involved ensuring that team members had the resources they needed to continue their work, and I assisted in the build process for most of the exhibits.
I traveled to the museum ahead of the installation to receive the exhibit deliveries and help with the final installation and testing. Unfortunately, due to an incident with the shipping company arranged by the client, some exhibits were heavily water-damaged. In order to meet the opening deadline, I was immediately tasked with temporary replacement of the damaged PCBs and IO devices, using locally sourced parts and expedited shipping.

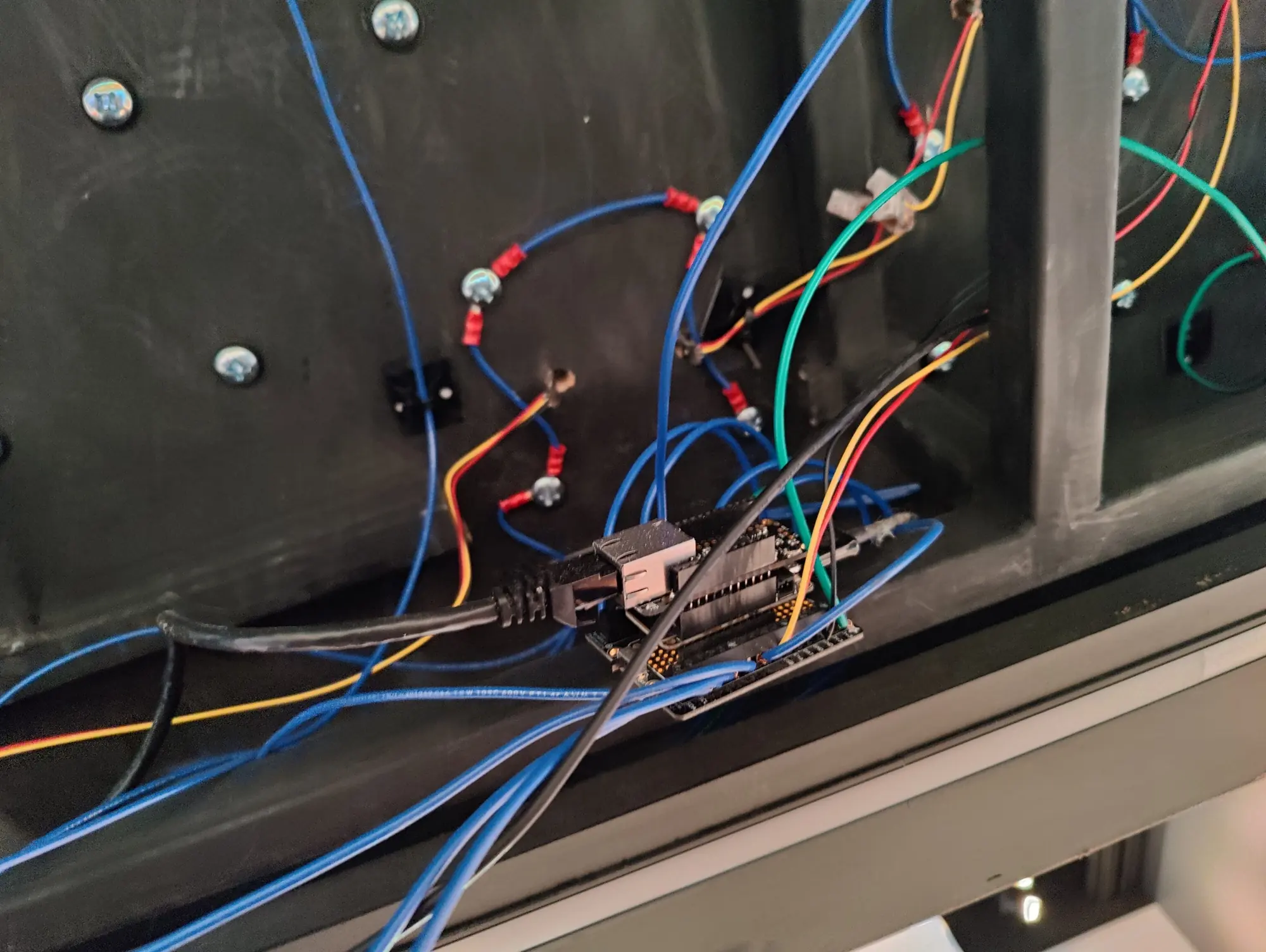

Emergency repairs

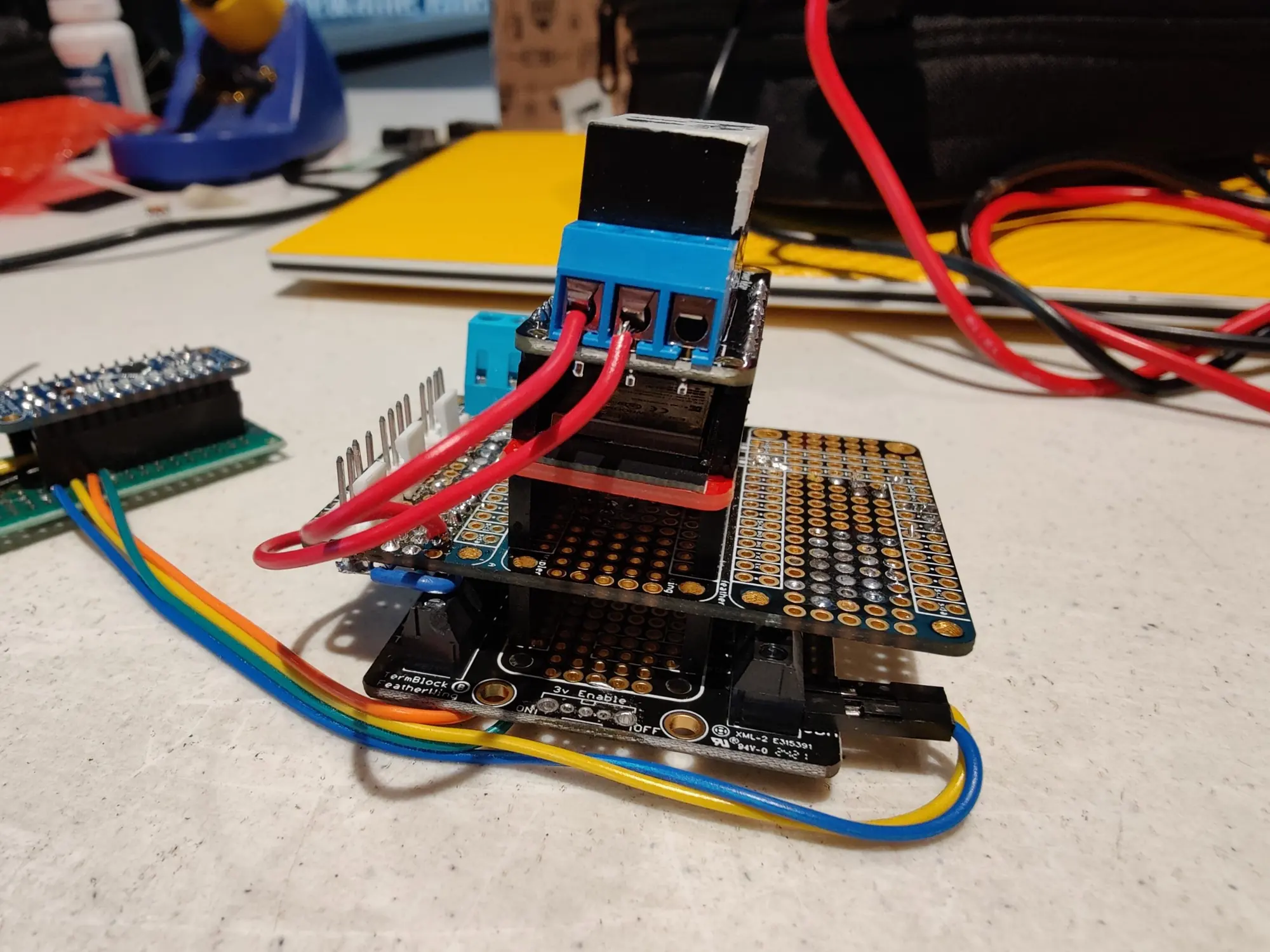

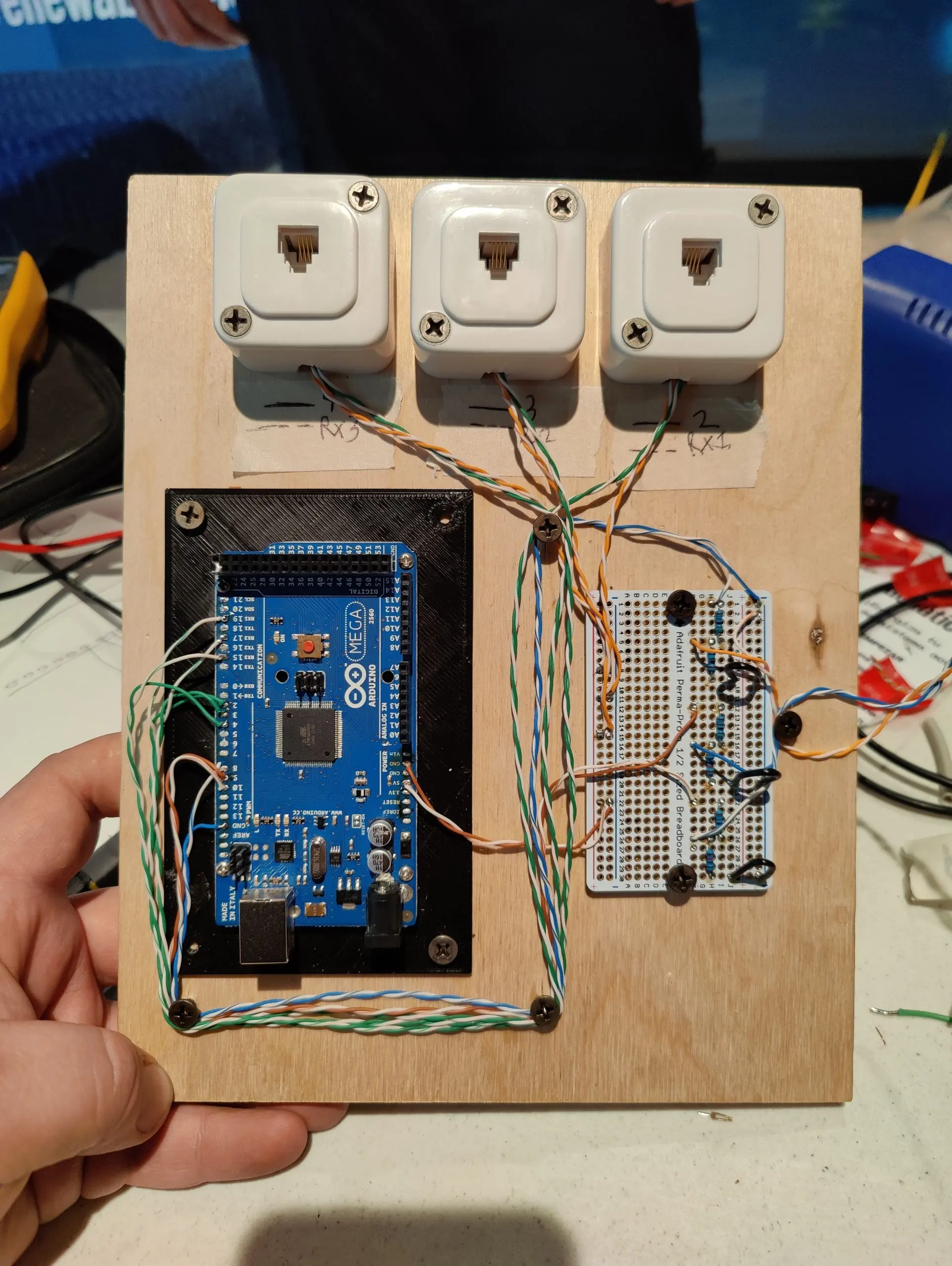

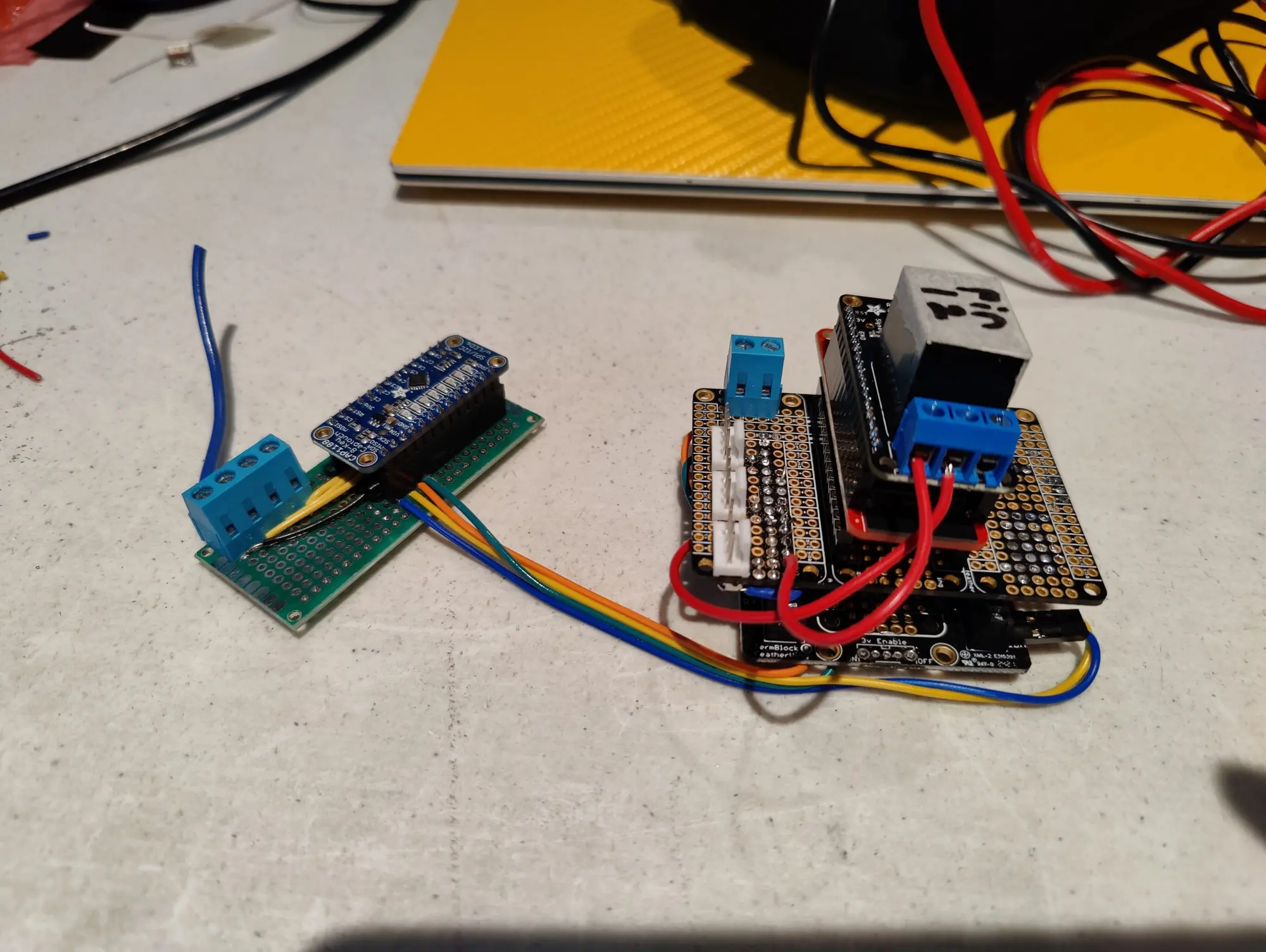

This period was extremely stressful for my team, but I am proud of the emergency repairs we managed to complete. The temporary electronic fixes, made with development boards and parts from hardware stores, functioned as intended and were hidden from view.
Overall, this project was both fun and challenging. I gained new skills and thoroughly enjoyed working on a project that would be appreciated by a wide audience.
Video · YouTubeLive from the Discovery Museum: a sneak peek of the new Energy exhibit (City of Reno)
